SAM Board Greenlights $13.2M Sewer Pipe Replacement After Governance Showdown

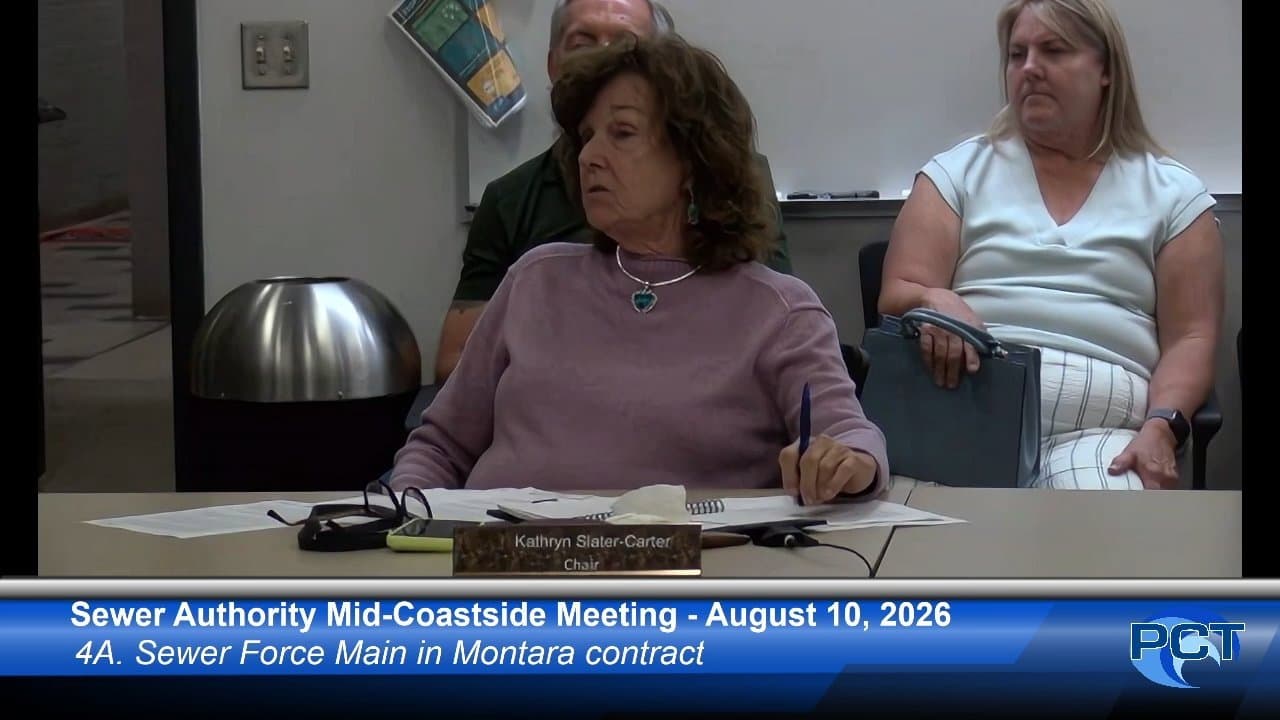

The Sewer Authority Mid-Coastside board spent more than an hour Monday night hashing out not whether to replace a failing two-mile sewer line in Montara — every director agreed the work is overdue — but who gets to say "go" first: SAM or the three cities and districts that fund it. The result was a unanimous compromise that keeps the project alive while sending a pointed message about fiscal process.
$13.2M sewer force main replacement contract with McGuire & Hester approved 5-0, but GM can't sign until all three member agencies confirm budget amendments in writing
Governance clash between GCSD directors and Montara representatives over whether the board jumped ahead of its own JPA rules on spending authority
Material costs climbing ~$100K per month; further delay risks contempt of court under a consent decree with the Ecological Rights Foundation
GM receives 4% pay raise (+$11,552 annually) to match union-negotiated increases, approved 5-0
Army Corps finds federal interest in a SAM-area shoreline project, potentially unlocking $400K in new appropriation
$13.2M Pipe Job Advances — With Strings Attached
The basics: SAM's force main in Montara — roughly 13,540 feet of ductile iron pipe installed more than 40 years ago — has experienced multiple failures and sewage spills. A 2019 consent decree with the Ecological Rights Foundation originally required completion by June 30, 2027. Staff recommended Option 2: an extended timeline to June 30, 2028, at a not-to-exceed price of $13,228,000, versus Option 1's $20.6M price tag to hit the original deadline.
Why it matters: Every month of delay adds approximately $100,000 in material cost escalation. The board is also operating under the shadow of a consent decree — if the Ecological Rights Foundation concludes SAM is stalling, the agency faces not a new lawsuit but contempt of court. "If they decide we are stalling, then we are not at risk for a lawsuit. We're at risk for a contempt of court, which is worse than a lawsuit," said Chair Kathryn Slater-Carter.
The Project
SRT Consultants Principal Engineer Rachél Lather walked directors through a detailed project overview, covering permits already secured — coastal development, Caltrans, and Regional Water Quality Control Board — along with remaining approvals from San Mateo County, the Army Corps of Engineers, and Fish & Wildlife. She laid out a risk register and contingency framework: $480,000 in contractor risk, $326,000 in SAM risk, and a $500,000 unplanned reserve. All contingency expenditures require prior written approval from the general manager. A peer review meeting with member agency engineers and general managers, held since the July board meeting, drew favorable feedback. Lather reported Option 1's total projected cost at $20,587,038 and Option 2 at $16,486,938 when non-construction consulting costs are included.
The Governance Rift
The real tension Monday had nothing to do with pipes. It centered on a procedural question: Can SAM's board authorize a contract that exceeds its approved budget before the three member agencies — Granada Community Services District, the City of Half Moon Bay, and Montara Water & Sanitary District — formally approve a mid-year budget amendment?
Vice Chair Nancy Marsh, representing GCSD, drew the line early. "I have a concern about the request to authorize the general manager to sign a contract when we have not gone through the process to approve funding that would support that contract," she said, adding later: "I think good governance says you make sure SAM has the money before you authorize SAM to spending money."
Director Barbara Dye, also representing GCSD, echoed the concern but stressed commitment to the project itself. "We are committed to this contract. We are committed to sign it. But we're following the advice of our attorney who believes that we have to operate consistent with the JPA," she said.
On the other side, Chair Slater-Carter and Director Scott Boyd, both representing Montara Water & Sanitary District, pressed for immediate action, citing the roughly $1 million in material cost escalation over the prior two years and the ticking consent-decree clock. Boyd, who said he had gone home after the July meeting and researched progressive design-build contracting in depth, pointed to global instability as another reason to lock in pricing. "With what's going on with the Strait of Hormuz, I don't see that settling out anytime before the election. Uncertainty drives price up," he said.
SAM Legal Counsel clarified that JPA Section 5(e) requires unanimous consent of all directors representing affected member agencies for expenditures exceeding the approved budget. Because Director Paul Nagengast (Half Moon Bay) was absent due to illness, a budget amendment could not be adopted at the table — it would need to go through each member agency's own board.
The Compromise
SAM Legal Counsel proposed the framework that ultimately became the final motion: authorize the GM to act, but only after each member agency communicates in writing that it has or will fund the project. Vice Chair Marsh formalized the language, moving to "authorize the GM to distribute the budget amendment request to member agencies and to authorize the general manager to sign the McGuire and Hester Option Two contract contingent on each member agency communicating in writing to SAM that they have or will fund the project consistent with Option Two, not to exceed $13,228,000, and contingent on finalizing the contract language."
A McGuire & Hester representative confirmed the firm's willingness to hold pipe pricing through Aug. 31 and absorb interim cost changes as a goodwill gesture.
Decisions: The motion passed 5-0 (For: Slater-Carter, Dye, Ruddock, Marsh, Boyd; Absent: Nagengast). If all three agencies approve within roughly 10 days, the GM could sign as early as late August, allowing pipe procurement to begin before further price escalation.
What's next: Granada CSD, the City of Half Moon Bay, and Montara Water & Sanitary District must each approve a mid-year budget amendment and notify SAM in writing. Remaining permits from San Mateo County, the Army Corps, and Fish & Wildlife are expected before construction begins.
Public commenter Kevin Hess urged rapid approval, citing the $100,000-per-month cost of delay, environmental and safety risks, and the possibility of a Super El Niño compounding damage to the aging line.
GM Gets 4% Raise to Match Union Increase
The board unanimously approved a 4% salary increase for General Manager Kishen Prathivadi, effective retroactively to July 1, 2026. The raise totals $11,552 annually, plus corresponding increases to payroll taxes, retirement contributions, and fringe benefits. The adjustment was required under the GM's fifth contract amendment, which tied management compensation increases to those negotiated for IUOE Local 39 represented staff.
Why it matters: The item is largely procedural — the increase was pre-committed last year — but it required formal oral disclosure and adoption of an amended salary schedule for CalPERS compliance under Government Code Section 54953(d)(3). Vice Chair Marsh reminded the board that the Operations Committee had updated the GM review process the prior year and urged directors to follow it; Director Dye noted a simplified review form had been created but not all board members had returned it.
Decisions: Passed 5-0 (Nagengast absent).
Minor Items
Consent agenda approved 5-0 with minor corrections to the July 13 meeting minutes regarding Director Dye's previous comments on exclusions and analysis.
Army Corps of Engineers found a federal interest in a SAM-area shoreline project; Director Deborah Ruddock noted that Congresswoman Zoe Lofgren is seeking a second appropriation of approximately $400,000 for additional work.
Landstrap parcel: SAM legal counsel reported upcoming meetings with the Half Moon Bay city attorney, with a real estate partner to be involved.
Cybersecurity: Director Barbara Dye requested a future closed-session briefing on cybersecurity, citing nationwide attacks on water and sewer utilities. "I would like to suggest that at our next meeting or as soon as you can do it that we do a closed session item on cybersecurity, given what's happening across the country with the water," she said.
Director Nagengast was absent due to illness; no alternate was appointed for the vacant position.
